California High-Speed Rail2018-04-16T15:48:56-08:00

California High-Speed Rail

The California High-Speed Rail (HSR) project carried a $40 billion price tag when first approved by voters in 2008. Eight years later, the government authority running the project estimated it will cost $64 billion. A revised business plan issued in March 2018 upped the cost to $77 billion and pushed the project back five years to 2033.

As outlined in the “Safe, Reliable High-Speed Passenger Train Bond Act for the 21st Century,” the HSR project will build approximately 800 miles of track up and down the state, connecting together most of the state’s large cities with up to 24 different stations.

Phase 1 promises a 2-hour and 40-minute ride between San Francisco’s Transbay Terminal and Los Angeles’ Union Station.

The project is expected to open in legs. The first, connecting San Jose to the Central Valley, is scheduled to begin passenger service in 2025. The second leg – expected to open in 2029 – will build out tracks from San Jose to San Francisco’s Transbay Terminal, including a Peninsula stop in Millbrae; and south from Bakersfield to Anaheim, with stops in Palmdale, Downtown Los Angeles, and at Burbank Airport.

The proposed timeline on the later extensions of the project aren’t as definite, but the state plans to add a 110-mile Sacramento extension, connecting to Modesto and Stockton on its way, and a 167-mile segment that snakes east from Los Angeles through the San Gabriel Valley to the Inland Empire, and eventually down south to San Diego.

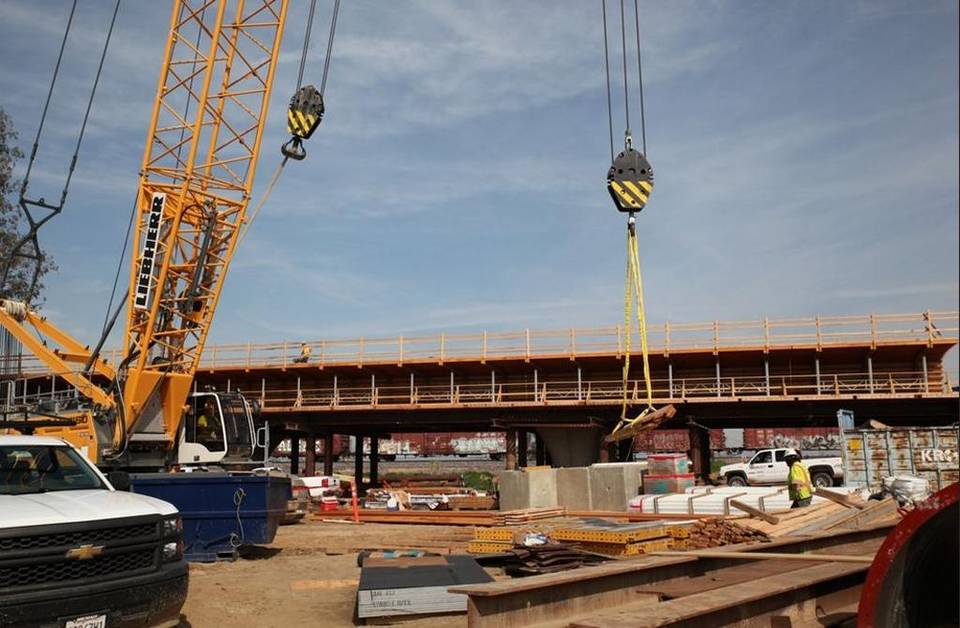

The High-Speed Rail Authority officially broke ground on the project in Fresno in 2015. Since then, construction crews have been working on a 119-mile segment of track in the Central Valley. Recently the rail authority reported $1.7 billion in cost overruns on the Central Valley segment.

As a measure to reduce project costs, the rail authority says it may abandon plans to build multi-million-dollar safety barriers near freight train tracks to prevent crashes and reduce the train’s speed in urban areas instead.

The California Legislature’s Audit Committee recently voted unanimously to audit the HSR Authority’s budget and expenditures.

Angelica Obioha, Infrastructure-Info Staff

California high-speed rail’s business plan criticized by the legislative analyst

Associated Press / San Jose Mercury News » California’s Legislative Analyst’s Office (LAO) urges state lawmakers to require the High Speed Rail Authority (HSRA) to provide more detailed information about the high-speed rail project’s cost and schedule. The LAO questions the project’s financing source, and reports difficulty in comparing cost over time because the HSRA makes several changes to the project’s plan every two years.

April 5, 2016|

Risks for rising cost increases on high-speed rail construction

The Fresno Bee » Based on a recent analysis, the California High Speed Rail Authority (HSRA) needs to increase the contingency allowance for Construction Package 1 by $150 million. The $1 billion contract for this 29-mile segment from Fresno to Madera was awarded in 2013 and includes a contingency allowance of $160 million. The HSRA says the amount is a projection and the Board must formally approve any increase. The $68 billion budget for the high-speed rail project includes an $11 billion contingency allowance. The HSRA will release a revised business plan with new cost estimates in early 2016.

February 16, 2016|

High-speed rail agency says construction costs are under control

The Fresno Bee » The California High Speed Rail Authority (HSRA) announced they are closely monitoring the project’s costs and schedule. The project’s estimated cost has changed several times over the years, raising concerns in the State Legislature.

February 6, 2016|

Bullet train’s first segment could open in the Bay Area instead of Southern California

Los Angeles Times » The California High Speed Rail Authority (HSRA) may change their course of action by building the northern San Jose to Bakersfield segment of the bullet train before constructing the most difficult and expensive southern segment from Burbank into the Central Valley. The HSRA is studying the feasibility and impact of this change.

January 23, 2016|

Spanish team poised to win new high-speed rail contract

The Fresno Bee » The California High Speed Rail Authority (HSRA) is expected to award a nearly $350 million design-build (D/B) contract to California Rail Builders, a private consortium which submitted the “approved best value” bid, for the design and construction of a 22-mile stretch of high-speed rail line. This would be the third D/B contract awarded by HSRA for work on California’s high-speed rail. The first two contracts were valued at $1 billion for a 29-mile stretch in Fresno, and $1.3 billion for a 65-mile stretch north of the Tulare-Kern County line.

January 5, 2016|
